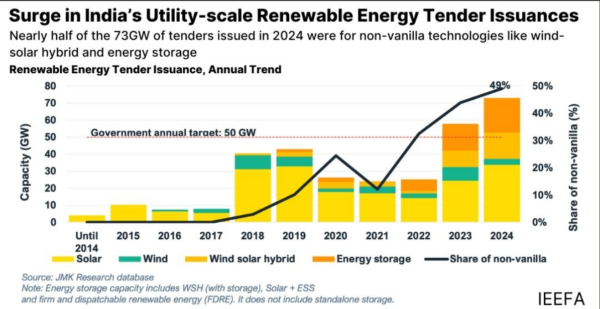

India issued tenders for a record 73 GW of utility-scale renewable energy capacity addition, eclipsing 2023’s 58 GW. This far exceeds the Ministry of New and Renewable Energy’s annual target of 50 GW, says a new report by the Institute for Energy Economics and Financial Analysis (IEEFA) and JMK Research & Analytics.
Half of the issued capacity in 2024 was for non-vanilla renewable technologies like wind-solar hybrid and battery energy storage in response to demand from energy offtakers for improved power quality.
“The evolution of renewable energy tenders demonstrates that market stakeholders are actively working to overcome shortcomings,” says the report’s contributing author, Vibhuti Garg, Director – South Asia, IEEFA.
“The renewable energy market has matured considerably, and all stakeholders, from investors to energy offtakers, have built a strong understanding of the intricacies of renewable energy technologies,” she adds.
The report also finds that the surge in tendering activity has brought fresh challenges that could temper investor enthusiasm and delay or cancel major projects.
“Tender undersubscription is emerging as a challenge for tendering authorities. Last year, about 8.5 GW of utility-scale renewable energy tenders went undersubscribed, five times more than in 2023, owing to complex tender designs, aggressive bidding during reverse auctions and delays in the readiness of the interstate transmission system (ISTS) infrastructure,” says the report’s co-author, Prabhakar Sharma, Senior Consultant, JMK Research.
Further, the report highlights delays in signing power sale agreements (PSA) with energy offtakers. The cumulative unsigned power sale agreement capacity has now exceeded 40 GW with Solar Energy Corp. of India (SECI)-led tenders alone accounting for 30% (12 GW).
From 2020 to 2024, 38.3 GW of utility-scale renewable energy capacity was cancelled, accounting for about 19% of the total issued capacity during that period. Cancellations were due to tender design issues, location or technical complexity, undersubscription and PSA delays, the report finds.
“Delays in project implementation pose a significant challenge to India’s renewable energy target for 2030,” says the report’s co-author, Ashita Srivastava, Senior Research Associate, JMK Research.
“Ongoing issues with project realisation could deter investor interest in future renewable energy projects in India, potentially affecting the availability of low-cost financing from large-scale investors,” he adds.
The report recommends authorities focus equally on all aspects of the tendering process, from issuance of requests for selection to allotment and signing of PSAs, to keep momentum high on adding renewable energy capacity via such tenders.
“In addition to issuing tenders, the government should establish annual targets for both allotments and the execution of PSAs. This will ensure that renewable energy implementing agencies (REIAs) issue bids only after securing the necessary offtake agreements,” says the report’s co-author Deepalika Mehra, Research Associate at JMK Research.
This content is protected by copyright and may not be reused. If you want to cooperate with us and would like to reuse some of our content, please contact: editors@pv-magazine.com.
By submitting this form you agree to pv magazine using your data for the purposes of publishing your comment.
Your personal data will only be disclosed or otherwise transmitted to third parties for the purposes of spam filtering or if this is necessary for technical maintenance of the website. Any other transfer to third parties will not take place unless this is justified on the basis of applicable data protection regulations or if pv magazine is legally obliged to do so.
You may revoke this consent at any time with effect for the future, in which case your personal data will be deleted immediately. Otherwise, your data will be deleted if pv magazine has processed your request or the purpose of data storage is fulfilled.
Further information on data privacy can be found in our Data Protection Policy.
